HydrogenShipbuilding.com

click to database
🚛

Truck-to-Ship Delivery

Mobile bunkering via tube trailers or cryogenic tankers—flexibility without port infrastructure investment

Back to Bunkering Methods Overview

Where fixed infrastructure doesn’t exist or vessels require refueling at multiple locations, truck-based delivery provides essential flexibility. This approach has been pioneered by early hydrogen vessel operators who needed to prove concepts before infrastructure investment could be justified.

Truck-to-ship bunkering has become the dominant method for the current generation of hydrogen vessels, enabling operations across multiple ports without requiring each terminal to invest in permanent hydrogen infrastructure. Both compressed and liquid hydrogen can be delivered by truck, though the equipment and procedures differ significantly.

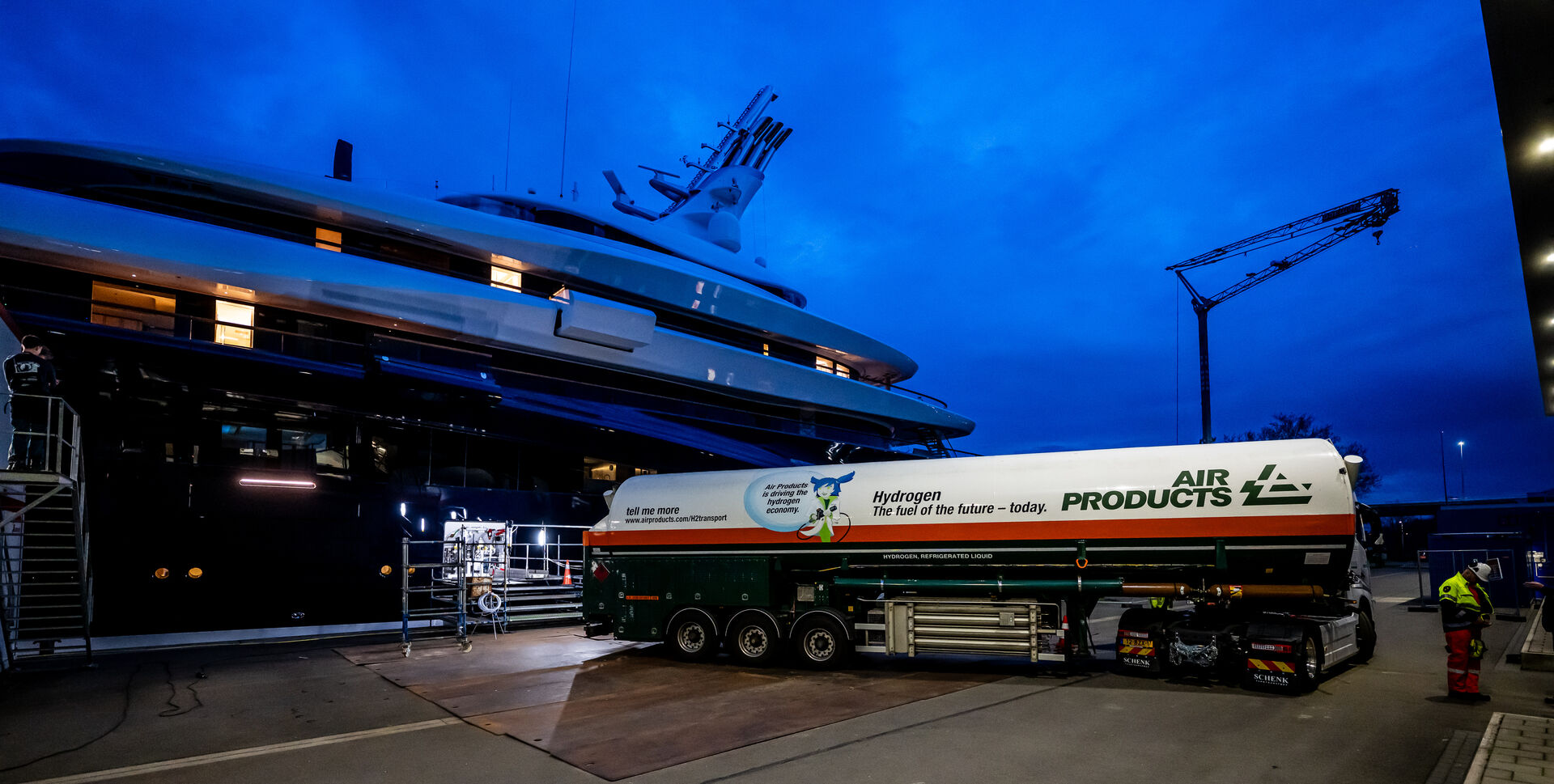

Truck-to-ship hydrogen bunkering operation showing tube trailer delivering hydrogen to vessel at quayside
Truck-to-ship delivery enables hydrogen bunkering at any port with quayside vehicle access.

Compressed Hydrogen (CH₂) Truck Delivery

Mobile tube trailers—road-transportable pressure vessels typically at 200–500 bar—connect directly to vessel fuel systems via standardized coupling equipment. This has become the dominant bunkering method for the current generation of compressed hydrogen vessels.

Windcat Offshore crew transfer vessel receiving compressed hydrogen from tube trailer at port
Windcat Offshore’s hydrogen-electric crew transfer vessels rely on truck-to-ship bunkering across multiple North Sea ports.

How It Works

Tube trailers containing 200–500 kg of compressed hydrogen are positioned quayside. Transfer occurs through cascade filling, with gas flowing from high-pressure trailer tubes to lower-pressure vessel tanks. Operations typically complete in 2–6 hours depending on volume and pressure differential.

Key Advantages

  • Minimal port infrastructure investment required
  • Bunker at any quay with vehicle access
  • Proven approach—multiple operators using today
  • Equipment can serve multiple vessels/ports
  • Lower operational complexity than LH₂

Operational Considerations

  • Transfer rates limited by pressure differential (50–150 kg/hour)
  • Multiple trailer trips may be needed for larger vessels
  • Fuel costs include transport markup
  • Weather and traffic can impact delivery schedules
  • Road weight limits may constrain payload
Best suited for: Offshore support vessels, crew transfer vessels, workboats, and any operation across multiple ports without dedicated hydrogen infrastructure.

Real-World Application: North Sea Operations

CMB.Tech and Windcat Offshore have pioneered truck-to-ship bunkering for their hydrogen-electric crew transfer vessels operating in the North Sea. This flexibility proved essential during early deployment when dedicated infrastructure simply didn’t exist at most offshore energy hubs.

Tube trailers are dispatched to whichever port the vessel’s operational schedule demands, eliminating the constraint of returning to a single bunkering location.

Liquid Hydrogen (LH₂) Truck Delivery

Cryogenic tanker trucks (typically 3,000–4,500 kg LH₂ capacity) connect to vessels via specialized transfer equipment. While more complex than compressed hydrogen truck operations, this approach enables LH₂ bunkering at any port with suitable quayside access—critical during the early deployment phase before fixed infrastructure develops.

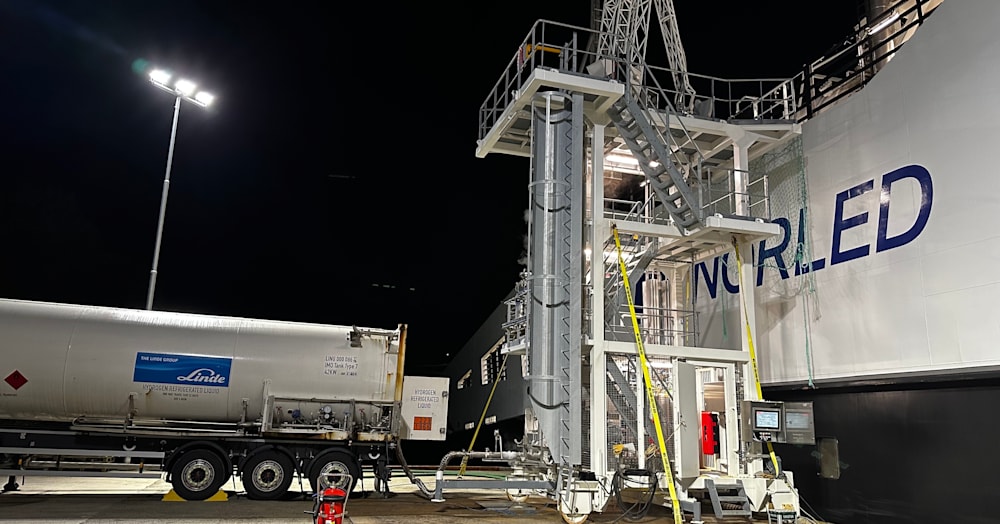

MF Hydra ferry receiving liquid hydrogen from cryogenic tanker truck at Hjelmeland, Norway
MF Hydra receives liquid hydrogen via cryogenic tanker truck at Hjelmeland, Norway—the world’s first LH₂ ferry bunkering operation.

How It Works

Vacuum-insulated tanker trucks transport LH₂ from liquefaction plants or import terminals to the vessel’s berth. Transfer occurs via cryogenic flexible hoses or fixed coupling systems, typically requiring 2–4 hours for a full bunkering operation depending on vessel capacity and pressure conditions.

Key Advantages

  • Enables LH₂ bunkering without port infrastructure investment
  • Flexible—serve multiple ports with same assets
  • Scalable as fleet grows
  • Lower barrier to entry for vessel operators
  • Can bridge gap until fixed infrastructure develops

Operational Considerations

  • Boil-off losses during transport and transfer
  • Limited to ports within economic trucking distance of supply
  • Weather sensitivity for cryogenic operations
  • Requires trained personnel at each bunkering
  • Road access and weight restrictions at some quaysides
Best suited for: Initial deployment phase of hydrogen vessels, ports without fixed infrastructure, and operators testing routes before committing to permanent solutions.

Operational Example: MF Hydra at Hjelmeland

Norled’s MF Hydra, the world’s first liquid hydrogen ferry, relies on truck-based LH₂ delivery at Hjelmeland, Norway. Cryogenic tanker trucks transport liquid hydrogen from the Linde facility to the ferry terminal, where bunkering occurs during scheduled turnarounds.

This approach enabled operational experience to accumulate while demonstrating the viability of liquid hydrogen as a marine fuel—proving the concept before committing to permanent shore infrastructure.

CH₂ vs LH₂ Truck Delivery Comparison

Parameter CH₂ Tube Trailer LH₂ Cryogenic Tanker
Typical Payload 200–500 kg 3,000–4,500 kg
Transfer Rate 50–150 kg/hour 200–500 kg/hour
Operating Conditions 200–500 bar, ambient 1–10 bar, -253°C
Transfer Duration (typical) 2–6 hours 2–4 hours
Equipment Complexity Moderate High (cryogenic)
Personnel Training High-pressure gas handling Cryogenic + high-pressure
Operational Status In Service In Service

Logistics & Planning

📍

Supply Chain Factors

  • Distance from H₂ production to port
  • Road access and weight restrictions
  • Delivery scheduling coordination
  • Multiple trips if vessel demand exceeds payload
  • Return trip logistics (empty trailers)
⏱️

Operational Planning

  • Align bunkering with vessel turnaround windows
  • Weather contingency for outdoor operations
  • Backup supplier arrangements
  • Safety zone establishment at quayside
  • Port authority coordination
💰

Cost Factors

  • Transport distance markup on fuel price
  • Trailer/tanker rental or ownership
  • Driver and operator costs
  • Boil-off losses (LH₂)
  • Multiple delivery fees if required
📋

Regulatory Requirements

  • ADR certification for road transport
  • Port dangerous goods protocols
  • Operator certification requirements
  • Emergency response procedures
  • Insurance and liability coverage

When to Choose Truck-to-Ship

Ideal Conditions

  • Operating across multiple ports
  • Testing new routes before infrastructure commitment
  • Ports without fixed H₂ infrastructure
  • Early-stage fleet deployment
  • Modest bunkering volumes
  • Need operational flexibility

Consider Alternatives If

  • Single-port, high-frequency operation (→ fixed installation)
  • Very large bunkering volumes required
  • Offshore bunkering needed (→ ship-to-ship)
  • Minimal turnaround time critical (→ container swap)
  • No H₂ supply within economic trucking distance
